India
Solar forecasting

India crossed 164.6 GW of installed solar in July 2026, and one third of the capacity recently commissioned cannot always reach the grid. Since 1 April 2026 the deviation band is half what it was. Both constraints resolve inside the same fifteen-minute block.

Solar forecasting in India

India crossed 164.6 GW of installed solar capacity on 31 July 2026, and added a record 15.3 GW in the first quarter of 2026 alone, 12.6 GW of it utility-scale. Gujarat and Rajasthan carried close to four fifths of those large-scale additions.

The constraint has moved with them. Around one third of the renewable capacity recently commissioned in India now faces grid curtailment, and under temporary general network access the curtailed share reaches 50 to 60% during solar generation hours. Curtailment is most pronounced in exactly the two states that are building fastest.

A second constraint arrived on 1 April 2026. The tolerance band for solar and wind-solar hybrid stations moved from plus or minus 10% to plus or minus 5%, so every 15-minute block that leaves the band is charged twice as easily as in 2025.

Together these two forces change what a schedule is worth. Output that cannot be evacuated has to be stored or shifted, and output that is declared wrongly is charged. Both decisions are made inside the hour.

Curtailment first, deviation charges second

Indian solar is scheduled in 15-minute blocks. The generator, or a Qualified Coordinating Agency acting for it, submits a day-ahead schedule to the load despatch centre and revises it during the day. Settlement compares injection to schedule, block by block, and charges the gap.

Curtailment sits upstream of that. Transmission build-out is running behind connection, with a pipeline of 107 GW awaiting interstate integration between the 2026 and 2031 financial years, and transmission projects still exposed to land acquisition and right of way delays. Curtailment erodes plant load factors by up to four percentage points in the states with the highest penetration.

The deviation charge is concentrated, not spread. On a 150 MW plant in the SRLDC area between October 2023 and March 2024, the blocks deviating by more than 30% were 2.35% of all blocks and carried 45.12% of the penalty paid. Forecasting in India is a tail problem.

Solar in India: the market in figures

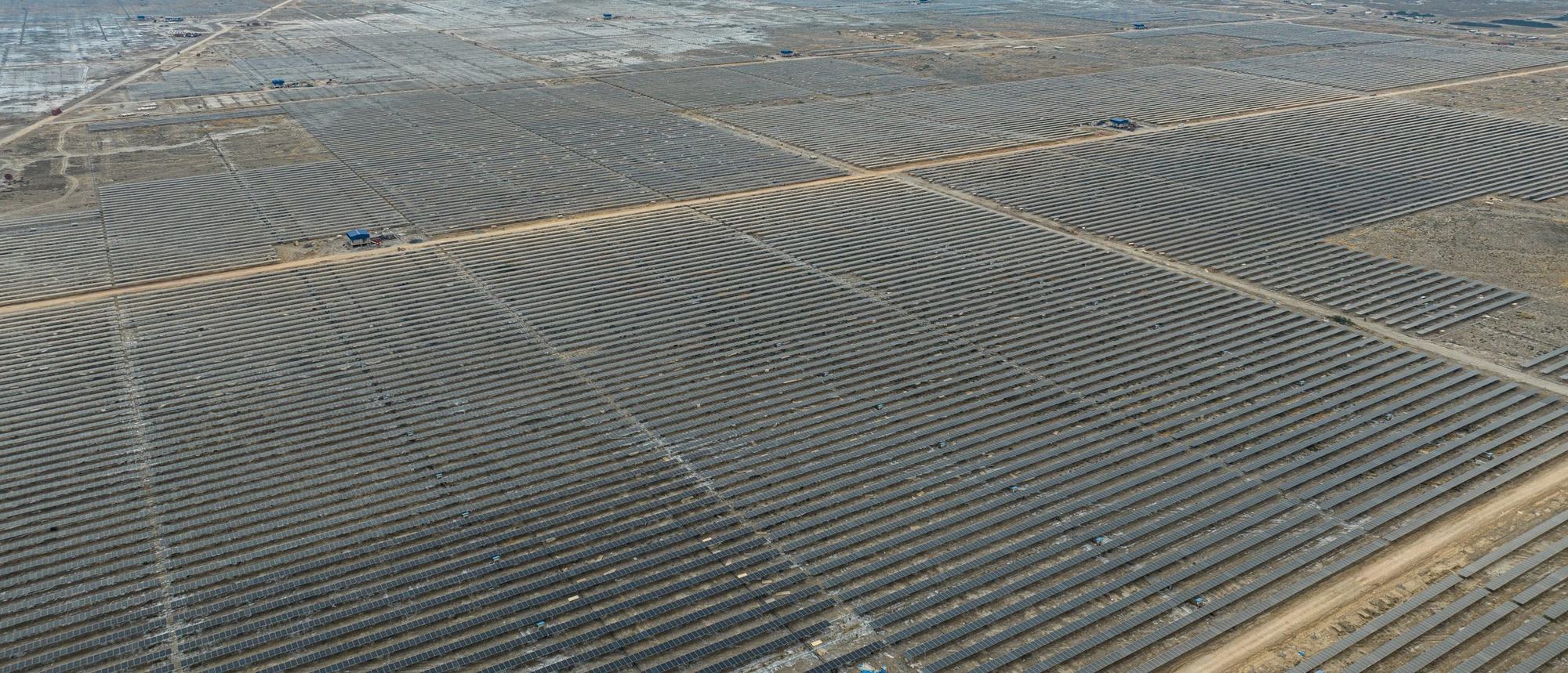

Photo: Adani Green Energy Limited (AGEL)

India is the second-largest national market for renewables growth worldwide, with close to 345 GW of renewable capacity expected between 2025 and 2030, nearly 60% of it auction-driven utility-scale solar.

Among them, Khavda in Gujarat: the world’s largest PV plant, with 20 GW of solar capacity under development, where CalibSun provides solar production forecasting for Adani Green Energy.

The physical loss is not theoretical. On a 350 MW plant in Bikaner, clear-day generation averaged 2,843 MWh while the worst cloudy day delivered 310 MWh, a shortfall of 89%. The schedule for that day had been submitted the day before.

Indicator

Value

Source

Installed solar capacity

164,595 MW at 31 July 2026

MNRE, physical progress

Solar added in the first quarter of 2026

15.3 GW, a record, 12.6 GW utility-scale

SPDA, June 2026

Share taken by Gujarat and Rajasthan

Close to four fifths of large-scale additions

SPDA, June 2026

Renewable capacity facing curtailment

33% of 54.8 GW recently commissioned

ICRA, May 2026

Curtailment under temporary network access

50 to 60% during solar hours

ICRA, May 2026

Effect on plant load factor

Up to 4 percentage points in high-penetration states

Mordor Intelligence, 2026

Deviation tolerance band since 1 April 2026

Plus or minus 5%, against 10% before

CERC Order, Petition 9/SM/2025

Key context

Two constraints now act on the same 15-minute block. Curtailment decides how much of the available output can physically reach the grid, and the deviation band decides how much of what is declared has to be delivered. A plant that forecasts well manages both. A plant that does not pays twice.

CERC, the states, open access, and now storage

What a tighter deviation band costs
Source: Sustainable Projects Developers Association

Four rulebooks on the same 15-minute block

CERC governs inter-state entities. It halved the solar tolerance band on 1 April 2026 and set a trajectory for the coefficient X, which decides whether deviation is measured against available capacity or against the submitted schedule. X holds at 100% until 31 March 2027, then falls to 90, 75, 55 and 30%, and reaches 0% on 1 April 2031. As X falls the denominator shrinks, and the same absolute error yields a larger deviation.

Each state commission sets its own bands and charges for intra-state sales. Gujarat and Rajasthan concentrate both the new capacity and the curtailment, and their rules are not the central ones. The band, the revision gate and the charge schedule therefore differ from one connection point to the next.

Short Term Open Access adds a third clock. A plant selling through STOA books capacity for days or weeks rather than for the life of a contract, declares a schedule against that booking, and carries the deviation on it. Open access volumes are growing as commercial and industrial consumers buy directly, which means more plants scheduling more often, on shorter notice.

Storage is becoming a rulebook of its own. Large-scale battery integration is the answer the sector is giving to curtailment, and it changes the forecasting problem rather than removing it. A battery has to be told what to charge and discharge, block by block, against a forecast of what the plant will produce and of what the grid will accept. Get the minute-scale profile wrong and the battery arbitrages the wrong way.

Rulebook

What it sets

Why it matters to a forecast

Rulebook

What it sets

Why it matters to a forecast

CERC, inter-state

Tolerance band and the trajectory of X

Band halved on 1 April 2026, denominator shrinks from 2027

State commissions

Intra-state bands, charges, revision gates

Gujarat and Rajasthan differ from the central rules

Short Term Open Access

Booked capacity and the schedule against it

More plants scheduling more often, on shorter notice

Key context

This is the structural point. Curtailment, the deviation band, open access and storage dispatch are four different mechanisms, set at four different levels, and they all resolve inside the same 15-minute block. A forecast that is good on a national monthly average answers none of them.

Cloud conditions during the monsoon over Khavda, 31 July and 17 August 2024
Satellite imagery over the Kachchh region, 31 July 2024 and 17 August 2024. Analysis: CalibSun

The monsoon decides when the money is lost

Around 75% of the deviation charges an Indian solar plant pays in a year are paid during the monsoon and fog months.

The exposure is not annual, it is seasonal, and inside those days it concentrates in a handful of 15-minute blocks. That is why an annual accuracy average tells an operator almost nothing about its bill.

From June to September the south-west monsoon carries moisture from the Mascarene High across the Arabian Sea and the Bay of Bengal onto the subcontinent. For a plant in Gujarat or Rajasthan that is not one cloud field. It is two, stacked and moving in opposite directions.

CalibSun analyzed satellite imagery over the Kachchh region on 31 July 2024 and 17 August 2024, alongside ERA5 wind roses computed at 775, 500 and 300 hPa over 2020 to 2024. The pattern is stable. Fragmented low clouds arrive from the sea on a south-westerly flow and travel north-east. High-altitude layers overlay them, moving east to west.

A single cloud-motion vector from satellite imagery collapses that vertical structure into one plane. Geostationary imagery resolves at roughly 15 minutes and 3 km. Below the 15-minute block, that latency is comparable to the whole forecast horizon.

Region

Dominant constraint

Forecasting difficulty

Region

Dominant constraint

Forecasting difficulty

Kachchh and Banaskantha, Gujarat

Monsoon regime, two decoupled cloud layers

Cloud vector methods assume a single advected layer

Bikaner and Jodhpur, Rajasthan

Desert-scale plants, dust and winter fog

Fog days cut output by up to 89%

Tamil Nadu and Karnataka

Coastal convection, north-east monsoon

Cells form and dissolve inside one satellite frame

Key context

Indian cloud physics is not mid-latitude cloud physics. Peer-reviewed work on Indian forecasting regulation notes that convective clouds prevalent in India form and dissolve quickly, unlike the mostly advective cloud motion of mid-latitudes. Cloud vector methods assume advection. In a convective monsoon regime the assumption breaks.

Where the gap sits, and why a battery needs it

In a three-month blind benchmark run by the client across thirty PV sites, CalibSun ranked first of seven providers. On another European IPP’s own production data, NEXT reduced normalized mean absolute error against the incumbent satellite-based provider by 46% at 5 minutes, 33% at 15 minutes and 23% at 60 minutes. Beyond two hours every provider converges on the same weather models and the gap closes.

Those two horizons, 5 and 15 minutes, are exactly the ones a battery is dispatched on. A storage asset paired with a solar plant decides charge and discharge against the expected profile of the next few blocks, not against a daily total. It is the horizon where the curtailment can be absorbed instead of lost, and the horizon where the deviation is settled. The place where CalibSun is measurably strongest is the place where storage makes its money.

Horizon

What the market uses today

Where the gap sits

Horizon

What the market uses today

Where the gap sits

Day-ahead

Numerical weather prediction

Adequate at plant level

Intraday, one to four hours

NWP and satellite imagery

Local microclimate not resolved

One minute to one hour

No effective coverage

Cloud motion below satellite resolution

Pre-construction resource

Satellite databases only

No on-site measurement to calibrate

Key context

The revision gate sits close to two hours centrally and close to one hour in Gujarat. That is exactly the window where the measured gap is widest, and it is the window a satellite-based product cannot reach.

CalibSun in India: on-site data where the models stop

Global satellite models and numerical weather prediction describe the atmosphere in kilometers and in hours. The cloud about to cross a specific array sits below both. CalibSun measures it from the ground.

INSTANT, sub-30-minute nowcasting for monsoon ramps and storage dispatch

INSTANT deploys hemispherical sky imagers and pyranometers on the plant, updates every minute, and anticipates irradiance drops at second to minute resolution. An inner camera triangle covers clouds within 5 km, an outer triangle 5 to 30 km. Because it measures cloud height by stereoscopy rather than assuming it, it separates the two monsoon layers instead of averaging them.

That is the signal a co-located battery needs. Knowing a ramp is coming two minutes before it arrives is what allows the storage asset to charge the excess instead of the plant losing it to curtailment.

At the Loulo gold mine in Mali, INSTANT has run continuously and unattended since 2020, on a photovoltaic fleet tripled to 72 MWp over a 65 MW heavy fuel oil and diesel grid.

NEXT, intraday and day-ahead accuracy where deviation is settled

NEXT assimilates plant measurements from your SCADA, satellite imagery and a weather model ensemble, and returns quantile distributions per 15-minute block rather than a single trace, timed to the revision gates. It is software only, delivered by API, with no hardware on site. In an independent 30-site benchmark it ranked first of seven providers.

FUTURE, on-site measurement before the plant exists

FUTURE runs twelve months of on-site measurement at 5-minute resolution to correct satellite bias at source, taking irradiance uncertainty from around 5% to 0.5%. It produces a bankable typical meteorological year on ten years of corrected satellite history, with P50 and P90 structured for lenders, plus a 1-minute series for storage sizing.

Each plant has its own forecasting model, computed on AWS, and no data is shared between sites. Where regulation requires data to stay in the country, as in India or China, the database, the API and the forecasting compute are all hosted locally.

Data sovereignty

Data security

Need more information?
Get in touch!

Frequently Asked Questions

Around one third of the renewable capacity recently commissioned faces grid curtailment, 33% of 54.8 GW according to ICRA as of May 2026. Under temporary general network access the curtailed share reaches 50 to 60% during solar generation hours. It is most pronounced in Rajasthan and Gujarat, the two states building fastest.

Under the central framework the first volume limit is a deviation up to 5% of available capacity from 1 April 2026, against 10% until 31 March 2026, and the second runs up to 10%. Intra-state sales follow the applicable state regulation, which may differ. The coefficient X begins to fall in 2027, which tightens the same rule further.

Geostationary imagery resolves at roughly 15 minutes and 3 km, and cloud vector methods assume clouds are advected rather than formed and dissolved in place. Monsoon conditions stack two layers moving in different directions, and convective cells appear and disappear inside a single frame interval.

It moves the problem rather than removing it. A battery has to be told what to charge and discharge for each 15-minute block, against a forecast of plant output and of what the grid will accept. That decision is made at the 5 and 15 minute horizons, which is where the measured accuracy gap is widest.
